Skip to content

2. Eaves

In this section

Interface definition

Eaves are an essential component of a building’s roof, extending beyond the walls to provide protection from the elements and contribute to the architectural style.

Typically, eaves consist of the following components:

There are generally considered to be three types of eave – closed, open and boxed.

Interface requirements

Critical requirements for an eaves interface were summarised as follows:

Additionally, critical challenges were identified when providing an example of a standardised eaves detail:

Interface categorisation

Interface rules

The following are critical high-level rules for an eaves detail that should be complied with as part of a Transform-ER retrofit programme:

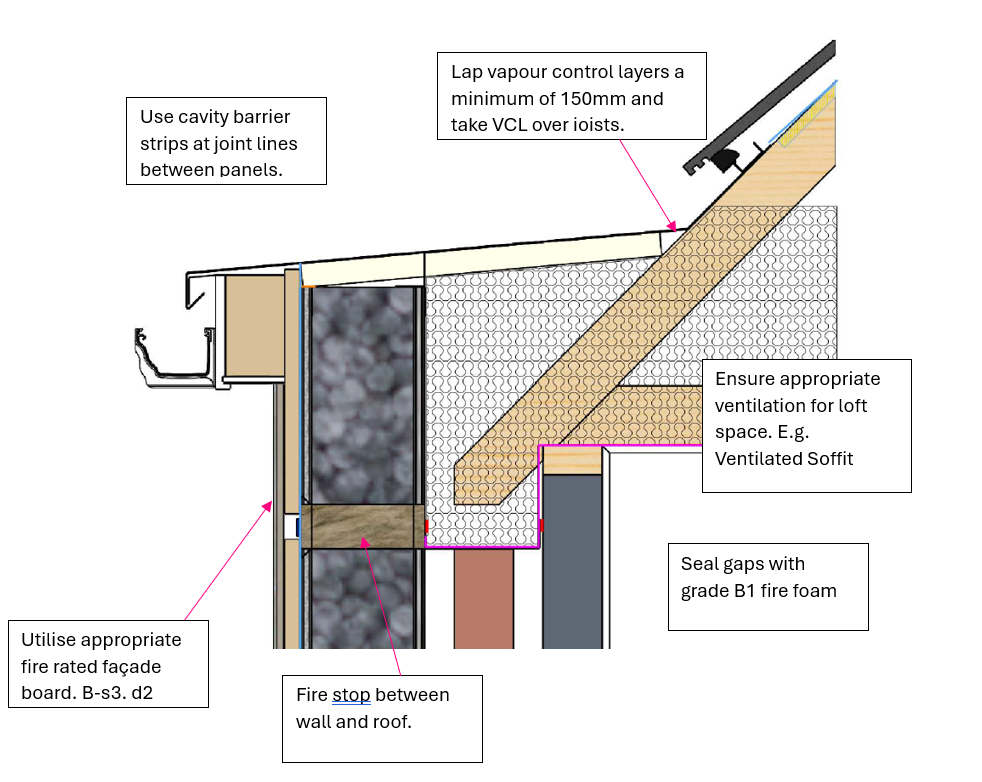

Eaves interface rules

Exemplar detail

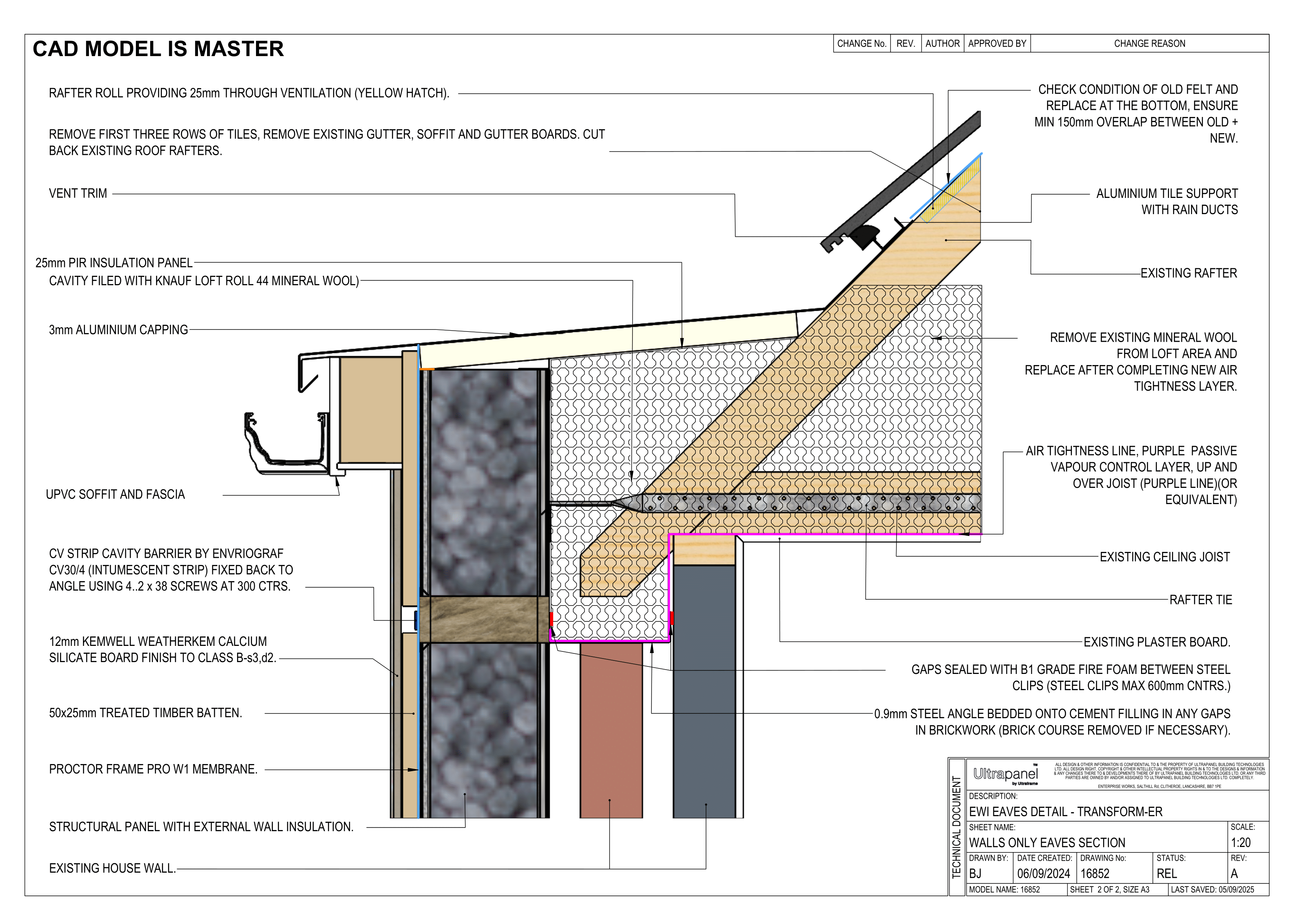

Below is an example of how Ultraframe’s system tackles an eaves interface detail, and the steps/procedure put in place to ensure weather tightness, insulative properties and fire resistance are maintained:

Testing and validation

It is important that the system provider considers how the external wall interfaces with the eaves and guttering to ensure that the claimed system performances are not adversely impacted due to this interface.

The external wall-to-roof interface is a critical junction requiring tailored detailing and validation. Using modelling, proven construction details, and robust inspection practices will ensure that systems remain thermally efficient, moisture resilient, and durable over the long term.

Manufacturers should consider providing a range of system-compatible detail options clearly noting any site-specific adaptions required.

Develop standardised detailing packages

When upgrading the external fabric of a domestic property, the junction between the external wall system and the roofline must account for a variety of conditions. Typical situations include:

Each of these conditions presents different risks in terms of thermal bridging, water ingress, and structural integration. Generic details and guidance are available in INCA Technical Guidance Document 06.

Design detail validation

Thermal performance

Moisture management

Water ingress

Structural integration

Relevance

Site validation

Detailing should be checked after the system is installed to confirm the validity of the proposed designs. Below are post installation checks that may be appropriate.
